| New Contracts, Extensions and Other Updates Since Last Fleet Status Report | ||||||||
Contract Backlog •Valaris has been awarded the following new contracts and contract extensions, with associated contract backlog of more than $160 million, subsequent to issuing its previous fleet status report on May 4, 2026. Contract backlog excludes lump sum payments such as mobilization fees and capital reimbursements. •Contract backlog is approximately $4.6 billion as of August 5, 2026. Floater Letter of Award (excluded from contract backlog as of August 5, 2026) •Letter of Award (LOA) for a two-well exploration program for VALARIS DS-18. The program is expected to commence in the fourth quarter of 2026 with a duration of up to seven months. •In conjunction with the LOA, Valaris and the operator of the previously disclosed contract for VALARIS DS-18 in the Gulf of America have amended the commencement date to be in direct continuation of the program related to the LOA. Jackup Contract Awards •101-day contract extension for VALARIS 248 with GE Vernova in the UK North Sea to provide accommodation support services for an offshore wind project. The contract extension commenced in June 2026 in direct continuation of the existing program and added approximately $7.5 million to contracted revenue backlog. •41-well plug and abandonment contract for VALARIS 248 in the UK North Sea. The contract is expected to commence in mid-2027 and has an estimated duration of 1,080 days. The firm term is expected to add approximately $140 million to contracted revenue backlog and is subject to an annual cost escalation mechanism effective from the commencement date. The contract also includes two unpriced one-year options. •A previously disclosed contract for VALARIS 248 with Eni in the East Irish Sea (UK) has been assigned to VALARIS 120. •One-well contract for VALARIS 123 with Central European Petroleum offshore Poland in the Baltic Sea. The contract is expected to commence in September 2026 for an estimated duration of 110 days and includes a priced option for a second well with an estimated duration of 30 days. The operating day rate is $135,000. | Middle East Operations Update •All Valaris and ARO rigs operating in the Middle East remain under contract. •VALARIS 250 completed its planned shipyard project and recommenced its bareboat charter with ARO in mid-July 2026. VALARIS 116 is expected to recommence its bareboat charter with ARO in the third quarter of 2026. •VALARIS 110 resumed operations with NOC offshore Qatar in late May 2026. Operations had been suspended since early March 2026 due to the conflicts in the Middle East. Other Fleet Status Updates •Jackups VALARIS 104 and 109 were sold in June and July 2026, respectively, for total cash proceeds of $74 million. Both rigs had been stacked for approximately six years. VALARIS 104 was sold for non-drilling use. •A previously disclosed one-well contract for jackup VALARIS 106 with Medco Energi offshore Indonesia was terminated by mutual agreement. | |||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||
Contract Backlog(1) (2) ($ millions) | 2026 | 2027 | 2028+ | Total | Contracted Days(1) (2) | 2026 | 2027 | 2028+ | |||||||||||||||||||||
| Drillships | $ | 559.2 | $ | 1,209.4 | $ | 1,247.7 | $ | 3,016.3 | Drillships | 1,312 | 2,788 | 3,015 | |||||||||||||||||
| Semisubmersibles | — | — | — | — | Semisubmersibles | — | — | — | |||||||||||||||||||||
| Floaters | $ | 559.2 | $ | 1,209.4 | $ | 1,247.7 | $ | 3,016.3 | Floaters | 1,312 | 2,788 | 3,015 | |||||||||||||||||
| Harsh Environment | $ | 119.4 | $ | 170.2 | $ | 140.9 | $ | 430.5 | Harsh Environment | 970 | 1,271 | 1,121 | |||||||||||||||||
| Benign Environment | 135.9 | 285.5 | 194.3 | 615.7 | Benign Environment | 986 | 2,216 | 1,842 | |||||||||||||||||||||
| Legacy | 29.7 | 57.5 | — | 87.2 | Legacy | 298 | 577 | — | |||||||||||||||||||||
| Jackups | $ | 285.0 | $ | 513.2 | $ | 335.2 | $ | 1,133.4 | Jackups | 2,254 | 4,064 | 2,963 | |||||||||||||||||
Other(3) | $ | 80.1 | $ | 109.4 | $ | 246.0 | $ | 435.5 | Other(3) | 1,255 | 2,315 | 5,422 | |||||||||||||||||
| Total | $ | 924.3 | $ | 1,832.0 | $ | 1,828.9 | $ | 4,585.2 | Total | 4,821 | 9,167 | 11,400 | |||||||||||||||||
ARO Drilling(4) | Average Day Rates(1) (2) | 2026 | 2027 | 2028+ | |||||||||||||||||||||||||
| Owned Rigs | $ | 107.0 | $ | 115.5 | $ | 491.4 | $ | 713.9 | Drillships | $ | 426,000 | $ | 434,000 | $ | 414,000 | ||||||||||||||
| Leased Rigs | 130.7 | 291.8 | 697.7 | 1,120.2 | Semisubmersibles | — | — | — | |||||||||||||||||||||
| Total | $ | 237.7 | $ | 407.3 | $ | 1,189.1 | $ | 1,834.1 | Floaters | $ | 426,000 | $ | 434,000 | $ | 414,000 | ||||||||||||||
| Harsh Environment | $ | 123,000 | $ | 134,000 | $ | 126,000 | |||||||||||||||||||||||
| Benign Environment | 138,000 | 129,000 | 106,000 | ||||||||||||||||||||||||||
| Legacy | 100,000 | 100,000 | — | ||||||||||||||||||||||||||
| Jackups | $ | 126,000 | $ | 126,000 | $ | 113,000 | |||||||||||||||||||||||
(1) Contract backlog, contracted days and average day rates as of August 5, 2026. (2) Contract backlog and average day rates exclude certain types of non-recurring revenues such as lump sum mobilization payments. Contract backlog and contracted days may include backlog and days when a rig is under suspension, except any backlog or days for rigs that are under a separate firm contract where backlog or days are otherwise included. Average day rates are adjusted to exclude suspension backlog and days. (3) Other represents contract backlog and contracted days related to bareboat charter agreements and management services contracts. (4) ARO Drilling contract backlog as of August 5, 2026. | |||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||

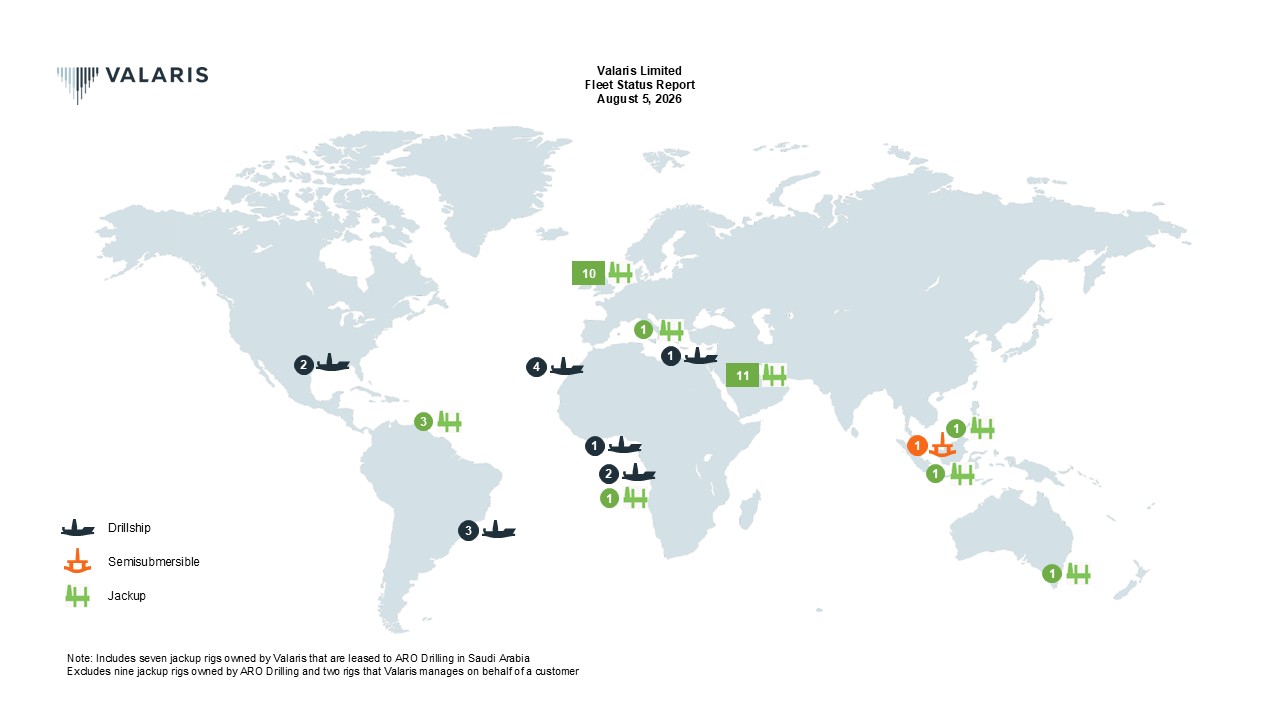

| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||

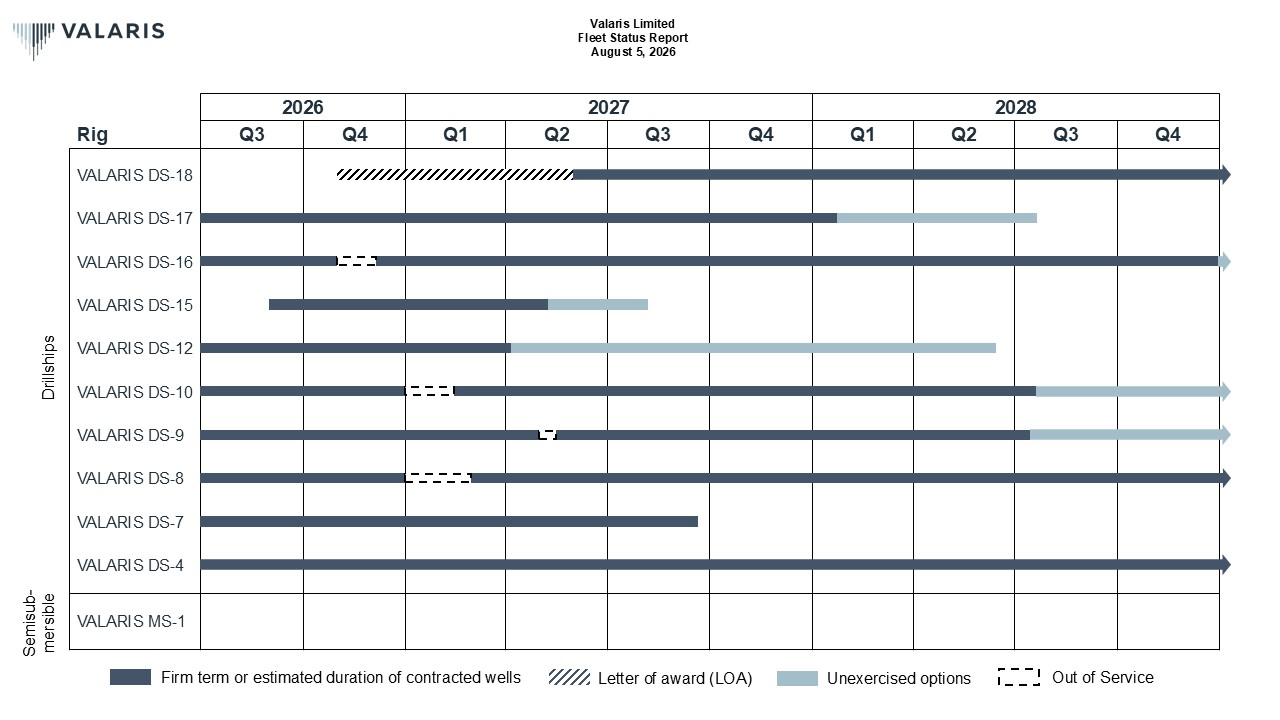

| Drillships | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-18 | GustoMSC P10000 | 2015 | Undisclosed Occidental | Undisclosed Gulf of America | Nov 26 Jun 27 | May 27 Dec 29 | LOA for a two-well exploration program with a duration of up to seven months 914-day contract for DS-18 and 940-day contract extension for DS-16. Combined addition to contracted revenue backlog is approx. $760 million. Two 1-year options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-17 | GustoMSC P10000 | 2014 | Equinor | Brazil | Mar 26 | Jan 28 | Estimated total contract value ("TCV") of $498 million, inclusive of MPD, additional services and fees for mobilization and minor rig upgrades. Based on initial estimated duration of 852 days comprised of a 180-day standby period and a 672-day drilling program. Three priced options with a total duration of 228 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-16 | GustoMSC P10000 | 2014 | Occidental Occidental | Gulf of America Gulf of America | Jun 24 Jun 26 | Jun 26 Dec 28 | Additional rate charged when MPD services provided 940-day contract extension for DS-16 and 914-day contract for DS-18. Combined addition to contracted revenue backlog is approx. $760 million. Two 1-year options. Expect approx. 35 days out of service for planned maintenance in 4Q26 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-15 | GustoMSC P10000 | 2014 | CNR | Spain Cote d'Ivoire | Sep 26 | May 27 | Rig is warm stacked in Las Palmas, Spain TCV, based on an estimated duration of 250 days, is approx. $135 million, including upfront payments for rig upgrades and mobilization. TCV does not include the provision of additional services. Priced options with a total estimated duration of 80 to 100 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-12 | DSME 12000 | 2013 | BP | Egypt | Apr 26 | Apr 27 | TCV, based on estimated duration of 350 days, is approx. $140 million, inclusive of MPD and mobilization. Three option wells | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-10 | Samsung GF12000 | 2017 | Shell | Nigeria | Jun 26 | Jul 28 | TCV of $352 million based on duration of two years. TCV does not include the provision of additional services. Additional rate charged when CML services provided. Two 1-year options. Expect approx. 45 days out of service for rig upgrades in 1Q27 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-9 | Samsung GF12000 | 2015 | ExxonMobil ExxonMobil | Angola Angola | Jul 22 Jul 26 | Jul 26 Jul 28 | Contract includes MPD services Operating day rate is in line with recent market rates in the region. Two 6-month options. Expect approx. 15 days out of service for planned maintenance in 2Q27 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-8 | Samsung GF12000 | 2015 | Petrobras Shell | Brazil Brazil | Dec 23 Mar 27 | Dec 26 May 29 | $428,000 | Plus mobilization fee of approx. $30 million. Contract includes additional services. Expect approx. 60 days out of service for rig upgrades in 1Q27 TCV of approx. $300 million, excluding additional services, based on estimated duration of 800 days. Options with a total estimated duration of approx. one year | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-7 | Samsung 96K | 2013 | Azule Energy Azule Energy | Angola Angola | Jun 24 Oct 26 | Oct 26 Sep 27 | TCV estimated to be $364 million based on initial estimated duration of 850 days Contract backlog of approx. $125 million based on estimated duration of 325 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-4 | Samsung 96K | 2010 | Petrobras Petrobras | Brazil Brazil | Dec 24 Nov 27 | Nov 27 Oct 30 | Previous day rate of $450,000 has been adjusted, reducing contract backlog from Apr 2026 to Nov 2027 by approx. $21 million. Plus mobilization fee of approx. $41 million. Contract includes MPD & additional services Contracted revenue backlog of approx. $447 million for 1,064-day extension | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-14 | DSME 12000 | 2023 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-13 | DSME 12000 | 2023 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS DS-11 | DSME 12000 | 2013 | Spain | |||||||||||||||||||||||||||||||||||||||||||||||
| Semisubmersible | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS MS-1 | F&G ExD Millennium, Moored | 2011 | Malaysia | Warm stacked | ||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||

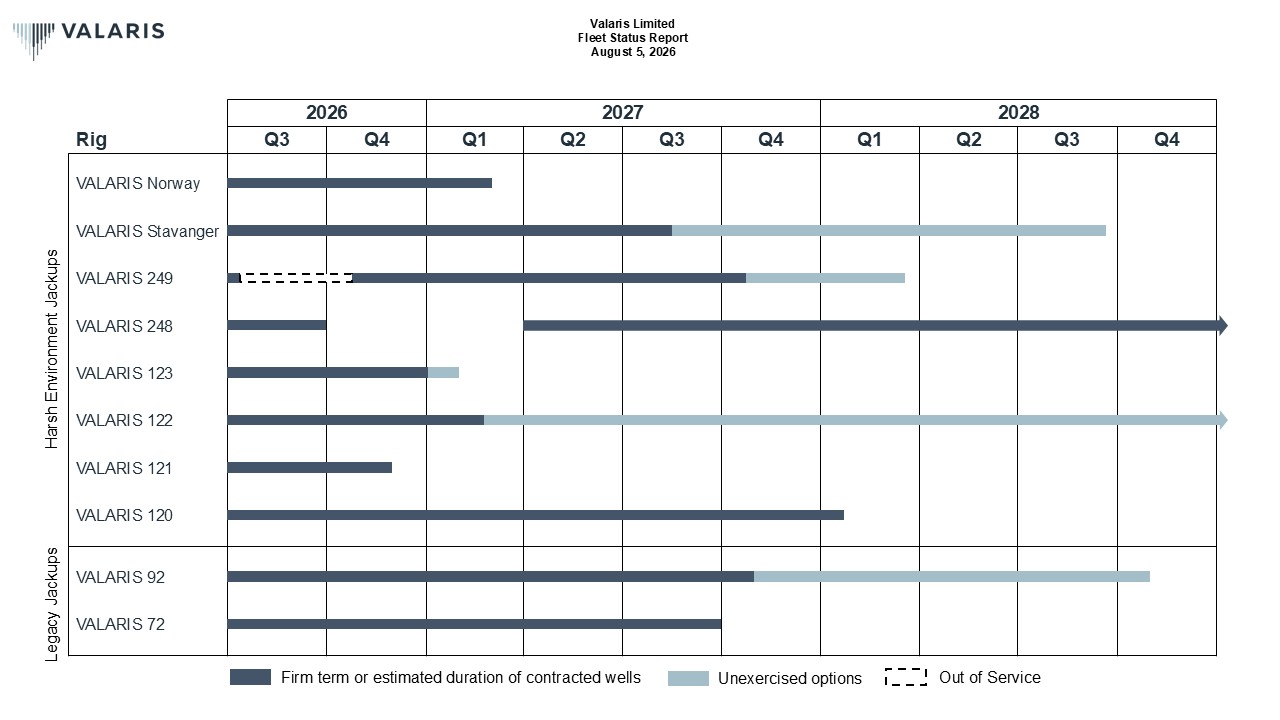

| Harsh Environment Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Norway | KFELS N Class | 2011 | Ithaca Energy Ithaca Energy | UK UK | Apr 25 May 26 | May 26 Feb 27 | TCV of approx. $39 million based on estimated duration of 292 days Contracted revenue backlog of approx. $36 million based on duration of 300 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS Stavanger | KFELS N Class | 2011 | NEO NEXT+ | UK | Jan 26 | Aug 27 | TCV of over $75 million based on 600-day priced extension. Two 200-day priced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 249 | LT Super Gorilla | 2001 | BP Shell | Trinidad Trinidad | Apr 26 Oct 26 | Jul 26 Oct 27 | TCV of $16.8 million based on duration of 100 days. Expect approx. 100 days out of service for planned maintenance in 3Q/4Q26 Contracted revenue backlog of approx. $66 million based on estimated duration of 365 days. Three priced options with an estimated duration of 50 days each | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 248 | LT Super Gorilla | 2000 | GE Vernova Undisclosed | UK UK | Nov 25 Apr 27 | Sep 26 Mar 30 | Contracted revenue backlog of approx. $23 million for 325-day contract to provide accommodation support services Contracted revenue backlog of approx. $140 million, subject to an annual cost escalation mechanism effective from the contract commencement date, based on estimated duration of 1,080 days. Two 1-year unpriced options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 123 | KFELS Super A | 2019 | TAQA CEP | Netherlands Poland | Jan 26 Sep 26 | Sep 26 Jan 27 | $80,000 $135,000 | Accommodation support Priced option with an estimated duration of 30 days | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 122 | KFELS Super A | 2014 | Adura INEOS | UK UK | Jan 26 Sep 26 | Sep 26 Feb 27 | $115,000 | Contracted revenue backlog of approx. $28 million for extensions totaling 243 days. The extensions are for accommodation support Options with an estimated total duration of 825 days for work in the UK and Danish North Sea | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 121 | KFELS Super A | 2014 | Adura | UK | Feb 26 | Nov 26 | Contracted revenue backlog of over $25 million based on estimated duration of 194 days | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 120 | KFELS Super A | 2013 | Eni | UK | Jan 26 | Jan 28 | Contract assigned to VALARIS 120 from VALARIS 248 | |||||||||||||||||||||||||||||||||||||||||||
| FLEET AWARD | Spirit Energy | UK | Commencement window up to Dec 2030; estimated duration of 294 days. Contracted revenue backlog of $35 million, subject to an annual cost escalation mechanism effective from the contract execution date. Three options with a total estimated duration of 426 days. Fleet award under which operations may be performed by any suitable and available rig within the Valaris North Sea Fleet | |||||||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS Viking | KFELS N Class | 2010 | UK | |||||||||||||||||||||||||||||||||||||||||||||||
| Legacy Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 92 | LT 116-C | 1982 | Shell | UK | Aug 25 | Oct 27 | Options with total duration of up to one year | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 72 | Hitachi 300C | 1981 | Eni | UK | Oct 25 | Sep 27 | ||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||

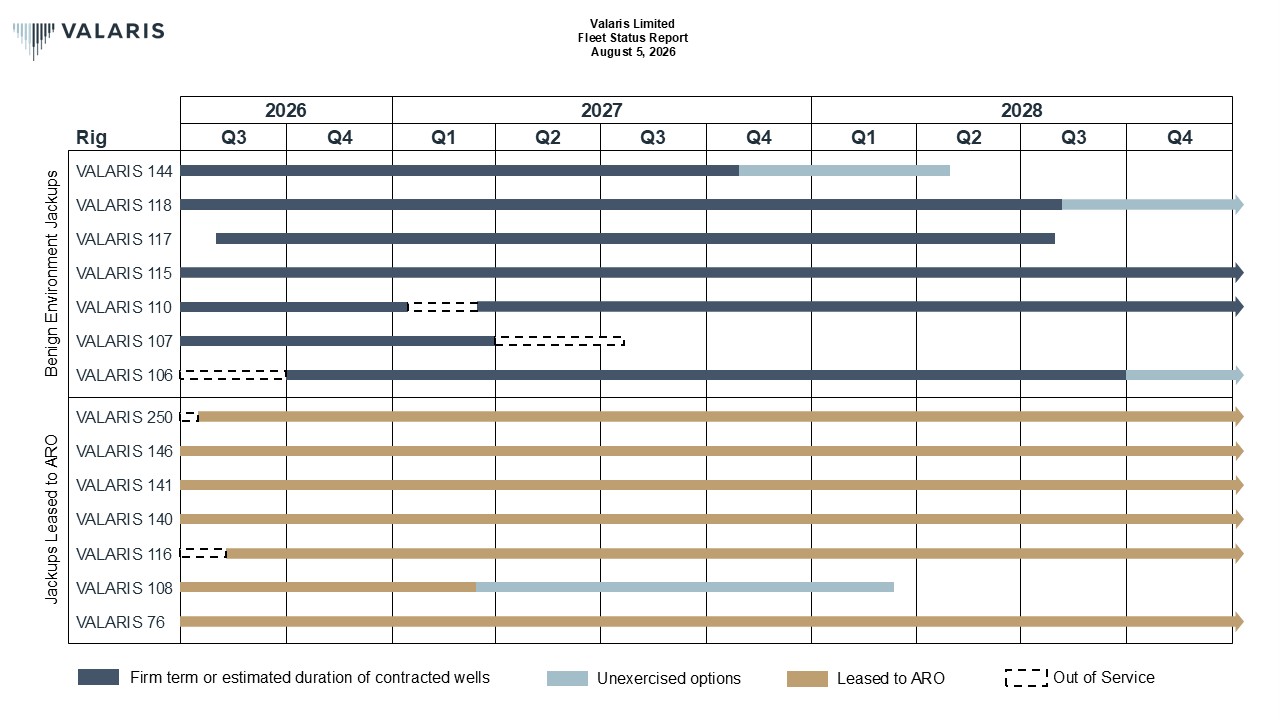

| Benign Environment Jackups | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 144 | LT Super 116-E | 2010 | Azule Energy | Angola | Sep 25 | Oct 27 | TCV estimated to be between $149 million and $156 million based on contract duration of 730 to 770 days, including a mobilization fee from the Gulf of America. Three-well option | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 118 | LT 240-C | 2012 | BP | Trinidad | Nov 25 | Aug 28 | TCV of approx. $168 million based on duration of three years. Two 1-year options | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 117 | LT 240-C | 2009 | Eni Undisclosed | Mexico Trinidad | Apr 25 Aug 26 | Apr 26 Aug 28 | TCV of approx. $36 million based on duration of 300 days Day rate in line with market rates in the region | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 115 | BM Pacific Class 400 | 2013 | Shell Shell | Brunei Brunei | Apr 23 Apr 27 | Apr 27 Apr 29 | TCV of approx. $159 million based on duration of four years Contracted revenue backlog of approx. $78 million for two-year extension | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 110 | KFELS MOD V-B | 2015 | NOC | Qatar | Oct 25 | Oct 29 | Contracted revenue backlog for the four-year extension is approx. $117 million. 1-year priced option. Expect approx. 60 days out of service for planned maintenance in 1Q27 | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 107 | KFELS MOD V-B | 2006 | Woodside GB Energy | Australia Australia | Nov 25 Nov 26 | Oct 26 Mar 27 | $163,000 | TCV of approx. $27 million based on estimated duration of 150 days. Expect approx. 115 days out of service for planned maintenance (including mobilizations) in 2Q/3Q27 | ||||||||||||||||||||||||||||||||||||||||||
| VALARIS 106 | KFELS MOD V-B | 2005 | BP | Indonesia | Oct 26 | Sep 28 | TCV of approx. $74 million based on estimated duration of two years. Four 1-well options. Expect approx. 90 days out of service for leg repairs in 3Q26 | |||||||||||||||||||||||||||||||||||||||||||
| Stacked | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 148 | LT Super 116-E | 2013 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 147 | LT Super 116-E | 2013 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 143 | LT Super 116-E | 2010 | UAE | |||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 111 | KFELS MOD V-B | 2003 | Croatia | |||||||||||||||||||||||||||||||||||||||||||||||
| Sold | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 109 | KFELS MOD V-Super B | 2008 | Namibia | Rig sold in July 2026 | ||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 104 | KFELS MOD V-B | 2002 | UAE | Rig sold in June 2026 for non-drilling use | ||||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||
| Asset Category / Rig | Design | Year Delivered | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | ||||||||||||||||||||||||||||||||||||||||||
Other - Jackups Leased to ARO Drilling(3) | ||||||||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 250 | LT Super Gorilla XL | 2003 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | Approx. 15 days out of service for planned maintenance in 3Q26. Recommenced bareboat charter in July 2026 following shipyard project | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 146 | LT Super 116-E | 2011 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | ||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 141 | LT Super 116-E | 2016 | ARO Drilling | Saudi Arabia | Aug 25 | Aug 30 | ||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 140 | LT Super 116-E | 2016 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | ||||||||||||||||||||||||||||||||||||||||||||
| VALARIS 116 | LT 240-C | 2008 | ARO Drilling | Saudi Arabia | May 25 | Apr 30 | Approx. 40 days out of service for planned maintenance in 3Q26. Expected to recommence bareboat charter in 3Q26 following shipyard project | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 108 | KFELS MOD V-B | 2007 | ARO Drilling | Saudi Arabia | Mar 24 | Mar 27 | 1-year priced option | |||||||||||||||||||||||||||||||||||||||||||
| VALARIS 76 | LT Super 116-C | 2000 | ARO Drilling | Saudi Arabia | Dec 25 | Dec 30 | Priced options of up to two years | |||||||||||||||||||||||||||||||||||||||||||
| Other - Managed Rigs | ||||||||||||||||||||||||||||||||||||||||||||||||||
| Thunder Horse | Deepwater Semisubmersible | BP | Gulf of America | Jan 24 | Jan 27 | TCV of approx. $153 million | ||||||||||||||||||||||||||||||||||||||||||||
| Mad Dog | Deepwater Spar Drilling Rig | BP | Gulf of America | Jan 24 | Jan 27 | TCV of approx. $106 million | ||||||||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||
| Asset Category / Rig | Design | Customer | Location | Contract Start Date | Contract End Date(1) | Day Rate(2) | Comments | |||||||||||||||||||||||||||||||||||||
| ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| Jackup Rigs Owned by ARO Drilling | ||||||||||||||||||||||||||||||||||||||||||||
| Gilbert Rowe | LT 116-C | Saudi Aramco | Saudi Arabia | Oct 17 | Sep 26 | |||||||||||||||||||||||||||||||||||||||
| SAR 201 | BM 200-H | Saudi Aramco | Saudi Arabia | Feb 18 | Sep 26 | |||||||||||||||||||||||||||||||||||||||
| Bob Keller | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Sep 26 | Expect approx. 30 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| J.P. Bussell | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 17 | Sep 26 | |||||||||||||||||||||||||||||||||||||||
| Scooter Yeargain | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | |||||||||||||||||||||||||||||||||||||||
| Hank Boswell | LT Tarzan 225-C | Saudi Aramco | Saudi Arabia | Oct 18 | Dec 26 | |||||||||||||||||||||||||||||||||||||||
| SAR 202 | KFELS Super B | Saudi Aramco | Saudi Arabia | Oct 17 | Sep 26 | |||||||||||||||||||||||||||||||||||||||
| Kingdom 1 | LT 116-C | Saudi Aramco | Saudi Arabia | Nov 23 | Nov 31 | Expect approx. 30 days out of service for planned maintenance in 3Q26 | ||||||||||||||||||||||||||||||||||||||
| Kingdom 2 | LT 116-C | Saudi Aramco | Saudi Arabia | Aug 24 | Aug 32 | Expect approx. 25 days out of service for planned maintenance in 4Q26 | ||||||||||||||||||||||||||||||||||||||
![]() | Valaris Limited Fleet Status Report August 5, 2026 | |||||||||||||
Out of Service Days (1) | ||||||||||||||||||||||||||||||||
| Rig | Segment / Asset Category | Q3 2026 | Q4 2026 | Q1 2027 | Q2 2027 | |||||||||||||||||||||||||||
| VALARIS DS-16 | Floater - Drillship | 35 | ||||||||||||||||||||||||||||||
| VALARIS DS-10 | Floater - Drillship | 45 | ||||||||||||||||||||||||||||||
| VALARIS DS-9 | Floater - Drillship | 15 | ||||||||||||||||||||||||||||||
| VALARIS DS-8 | Floater - Drillship | 60 | ||||||||||||||||||||||||||||||
| VALARIS 249 | Jackup - Harsh Environment | 75 | 25 | |||||||||||||||||||||||||||||
| VALARIS 110 | Jackup - Benign Environment | 60 | ||||||||||||||||||||||||||||||
| VALARIS 107 | Jackup - Benign Environment | 90 | ||||||||||||||||||||||||||||||
| VALARIS 106 | Jackup - Benign Environment | 90 | ||||||||||||||||||||||||||||||
| VALARIS 250 | Other - Jackups Leased to ARO Drilling | 15 | ||||||||||||||||||||||||||||||
| VALARIS 116 | Other - Jackups Leased to ARO Drilling | 40 | ||||||||||||||||||||||||||||||
